Insights

Resource Management Best Practices

5 mins read /
 04/10/2021 9:05 am
 04/10/2021 9:05 am
5 mins read
Mark E. Read PMP

Resource capacity and demand management (Resource Management for short) is one of the biggest pain points for organizations.  It’s also one of the most requested features in Microsoft Project and other project management solutions.

Many organizations are not getting the results they’re looking for because they struggle with the effort (discipline) required to maintain good data, not to mention a lack of tools to support ever-changing project needs, priorities, and resource availability.


Related: VIDEO: Project Management in Office 365 and Microsoft Teams

These challenges can all be overcome with a best-practices approach to resource management and a bit of attention to variances and exceptions.

In this blog post, I will outline the best practices for resource management; the video shows a walkthrough of how it works in real life.

Long Term vs. Near Term Planning

Long term planning is best done with generic roles in formal resource requests.  Then, once the proposal or project is approved on its merits, the resource manager can allocate named individuals that the project manager can assign to the detailed tasks on the project.

This approach enables organizations to look at resource demand further in the future without the need to specify named individuals right away.  When coupled with an understanding of team capacity, this enables organizations to anticipate hiring needs and to match their demand with recruiting timelines.


Download Now: Power BI template for Microsoft Project for the web or Power BI template for Microsoft Project Online.

Resource Management Process – Long Term vs. Near Term

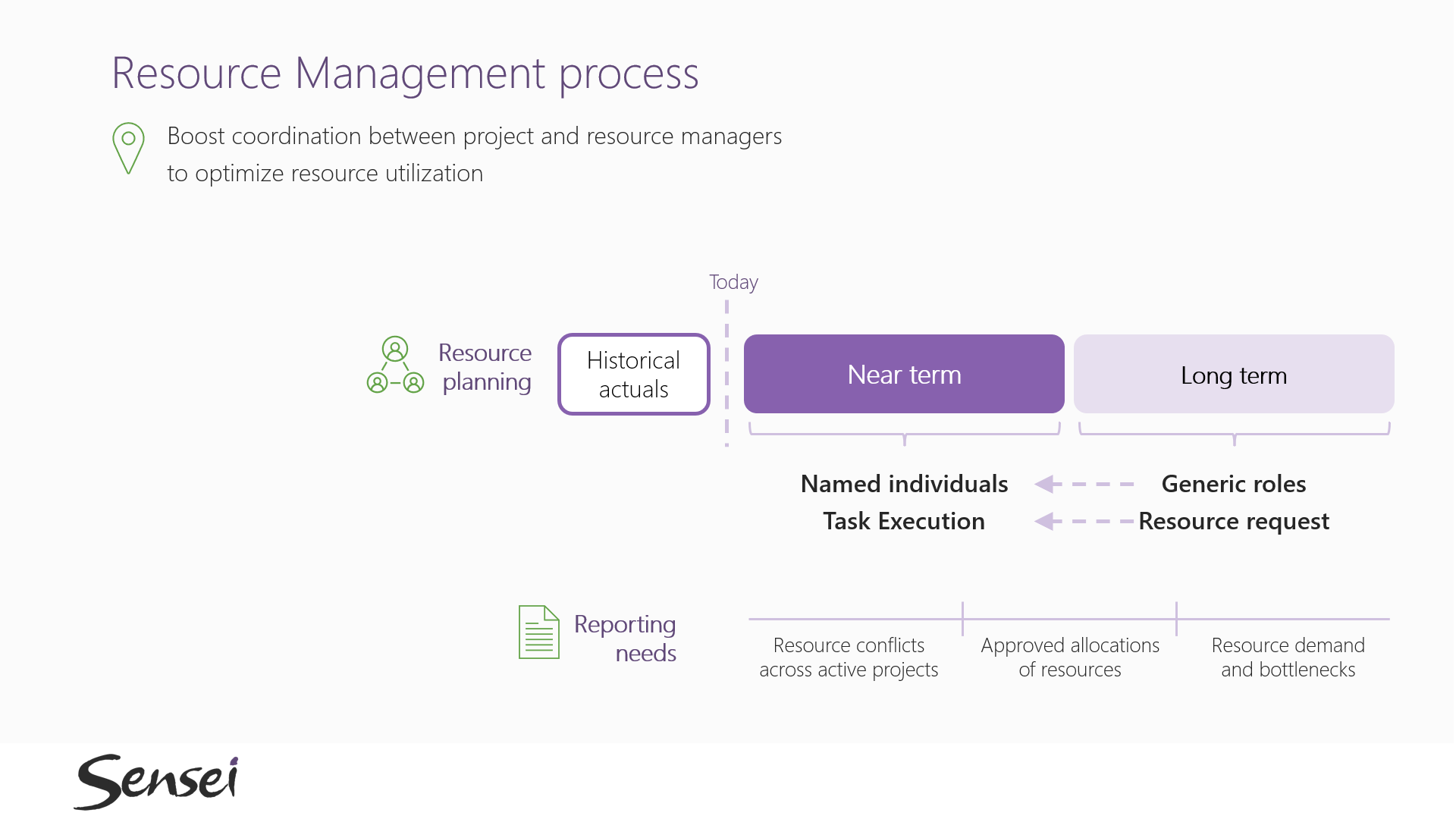

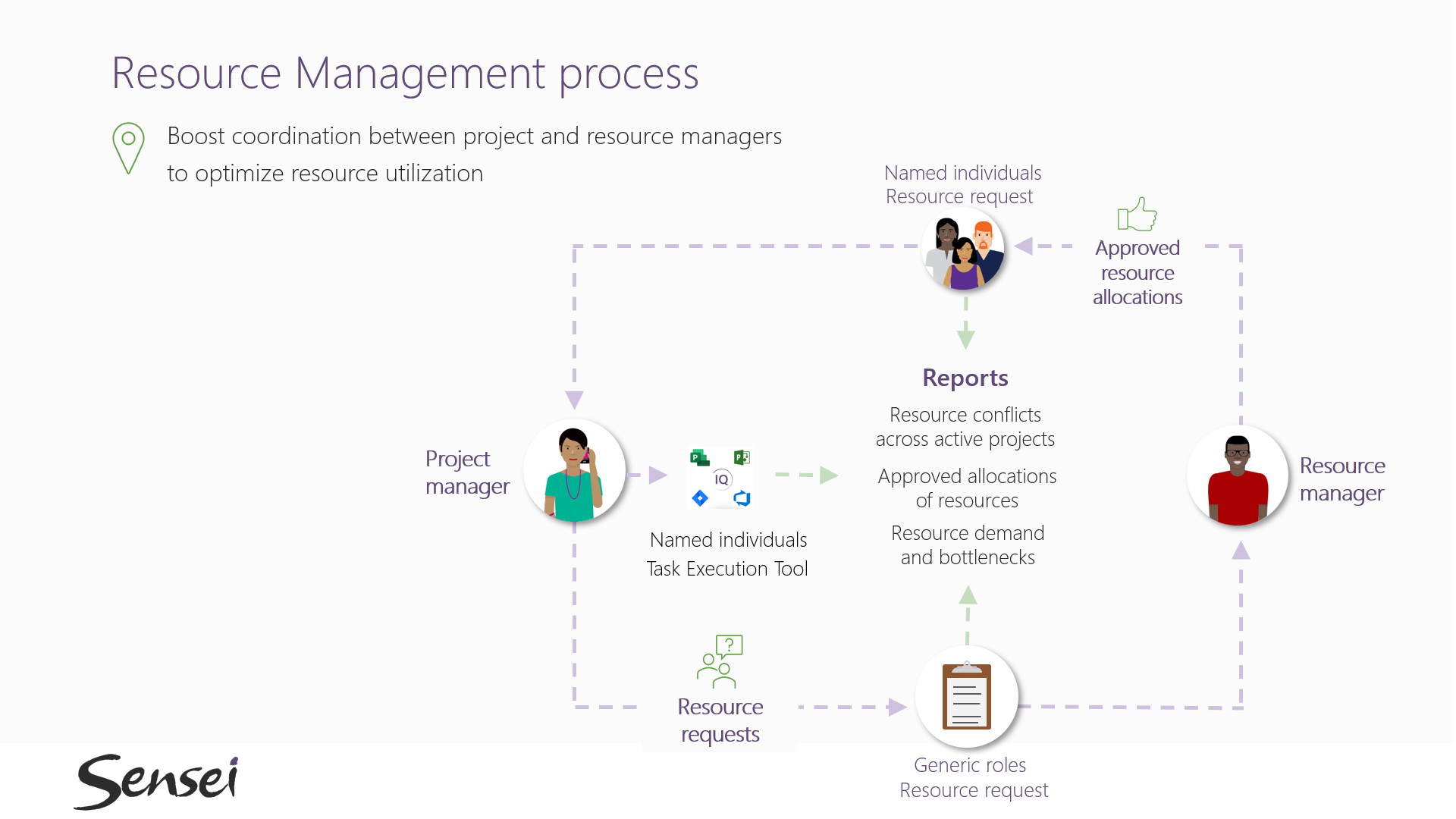

Resource Management Process

Having project managers and resource managers collaborate in a single tool is key, along with having real-time data to monitor for any exceptions.  The process is not complex, but it does require on-going monitoring and adjustments as things change.

Step-by-Step Resource Management Process

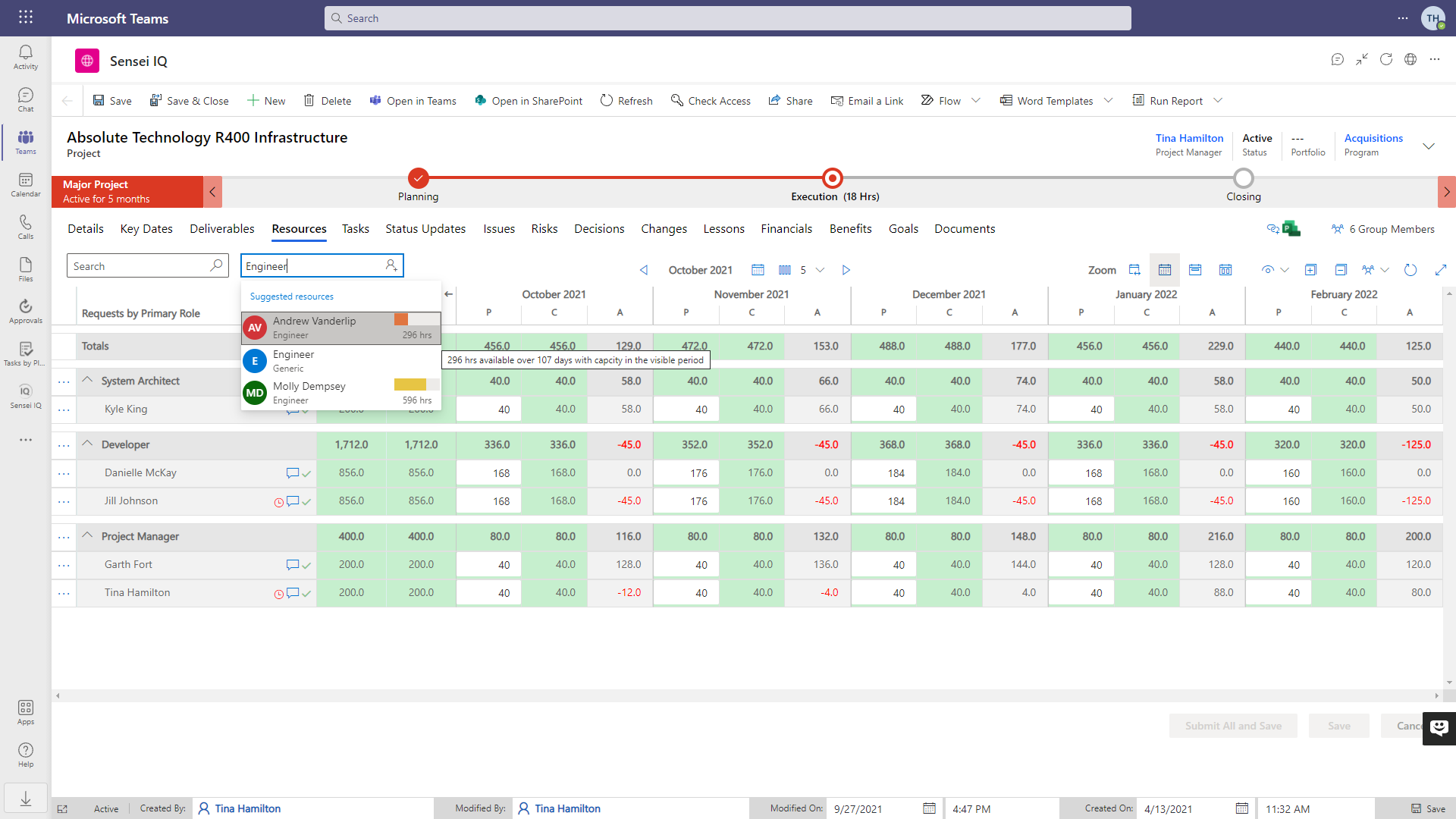

Resource Request for Proposal and Projects

The first step in the process is for the project manager to submit a formal resource request, which you can think of as the resource budget for the project.  Ideally, this should be done at the proposal stage, using generic roles instead of named individuals, especially if the planning is done months in advance.  In parallel, the proposal is evaluated on its merits. If the proposal is approved, it becomes a project

Resource Requests for Proposals and Projects

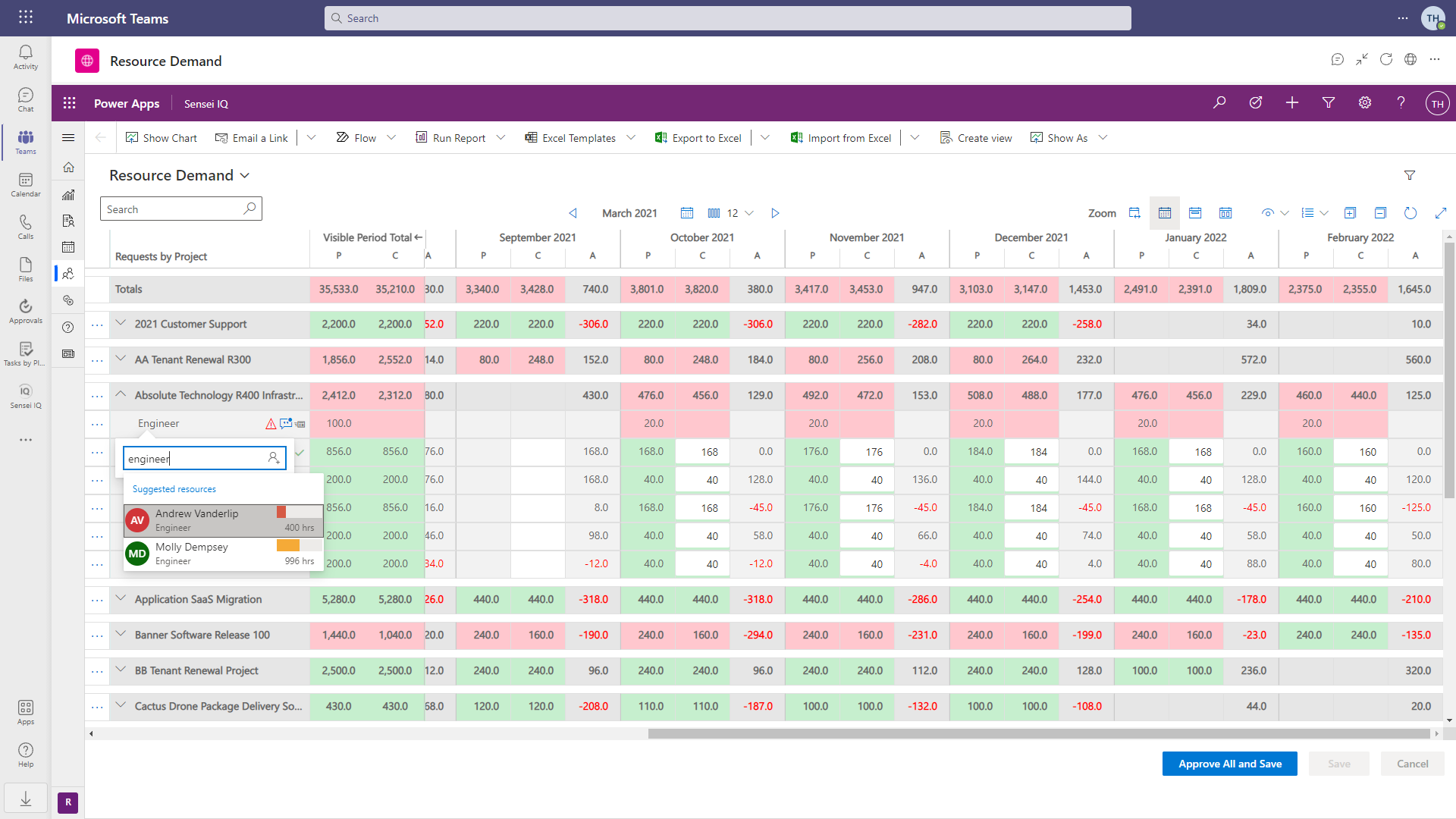

Approved Resource Allocations

If the proposal is approved, then the resource manager will need to staff the project.  This is done by approving the resource requests and allocating named individuals to the project.

Approved Resource Allocations





Assigned Work on Projects

Once the proposal/project is approved, the project manager is able to build out the detailed schedule with task assignments for the team, staying within the approved allocations of course.  And the key here is that this can be done across several different project management tools, such as Microsoft Project, Project for the web, Azure DevOps and Jira.

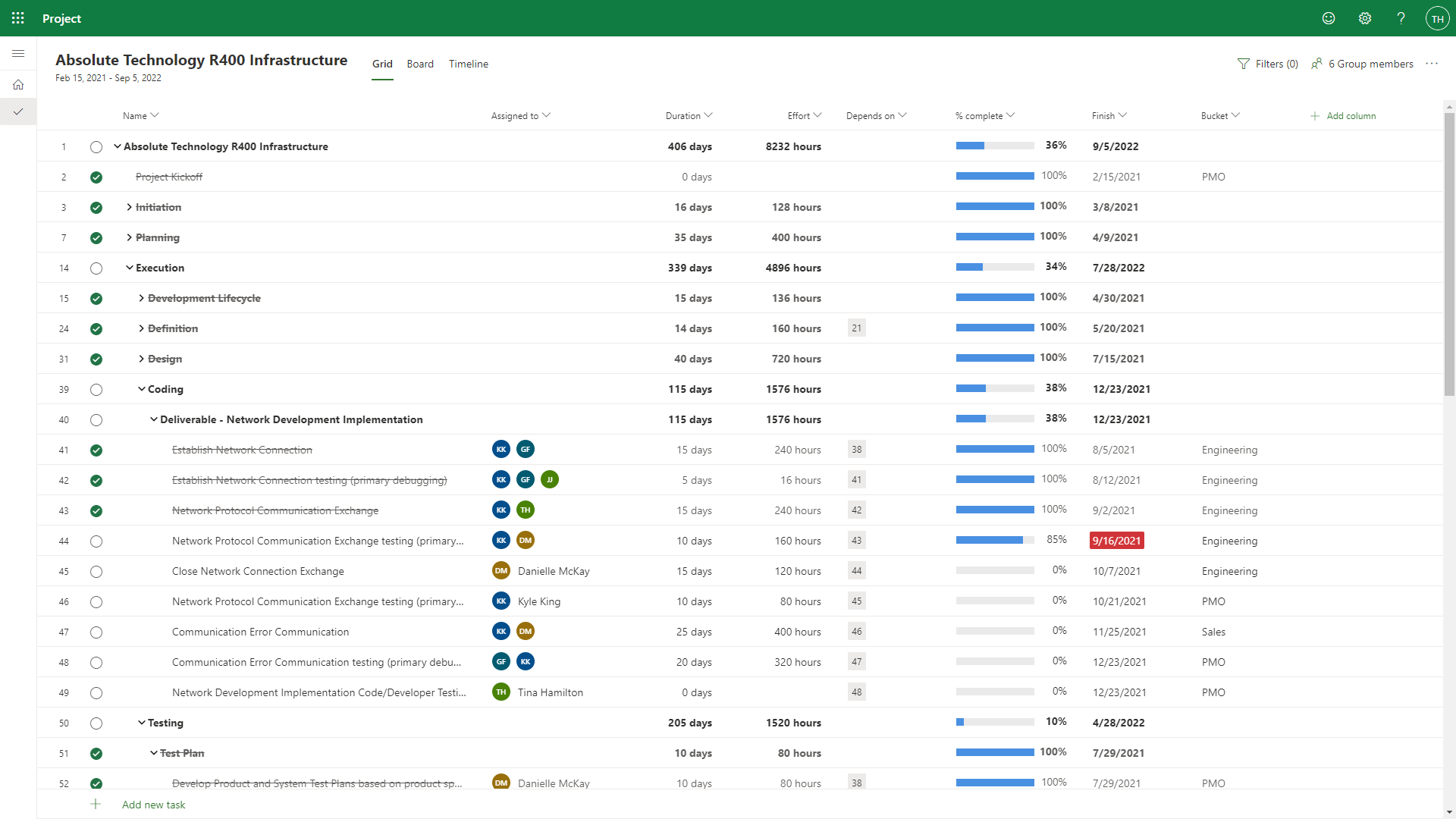

Assigned Work in Microsoft Project for the web – Grid View

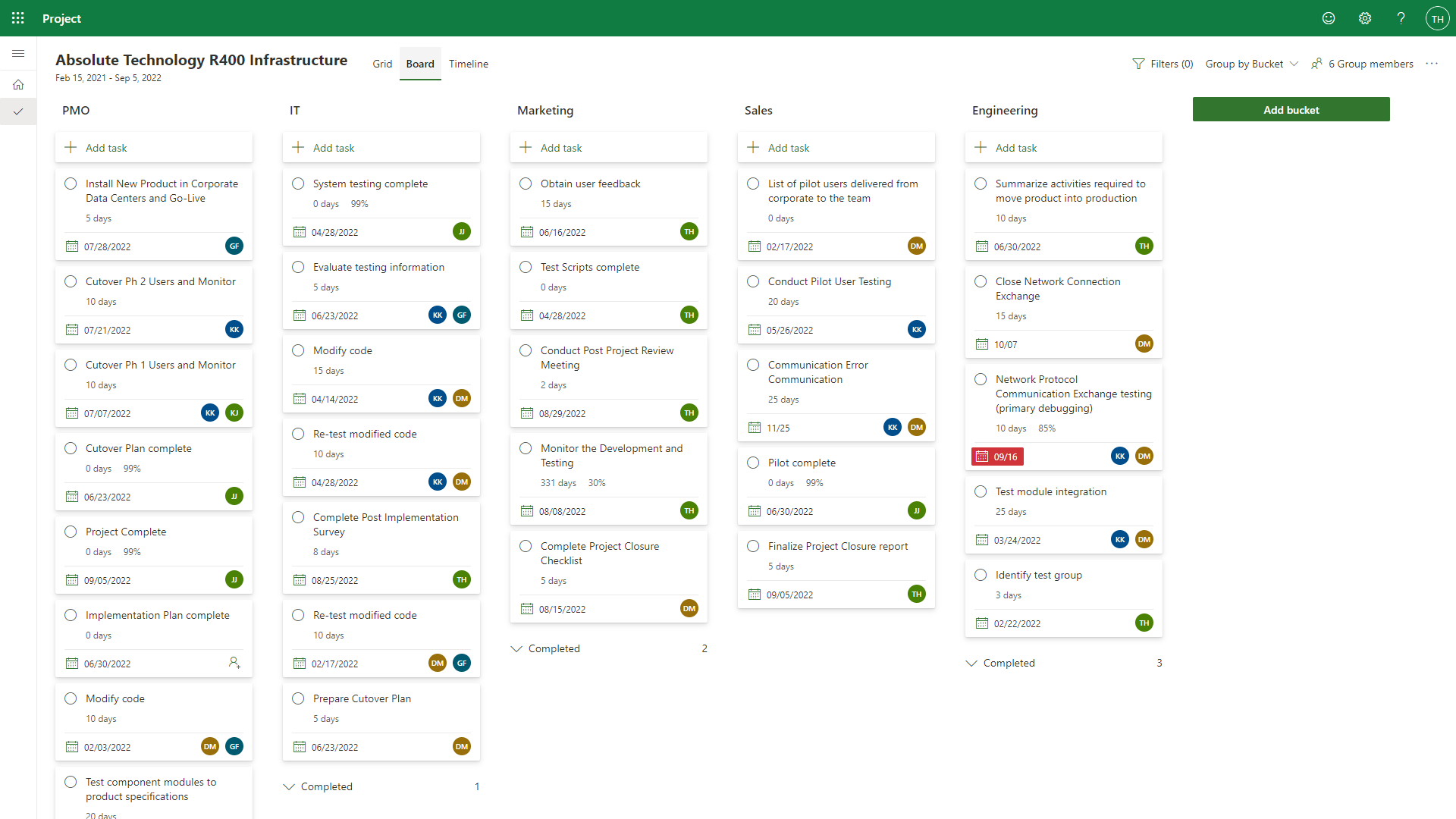

Assigned Work in Microsoft Project for the web – Board View



Assigned Work in Microsoft Project for the web

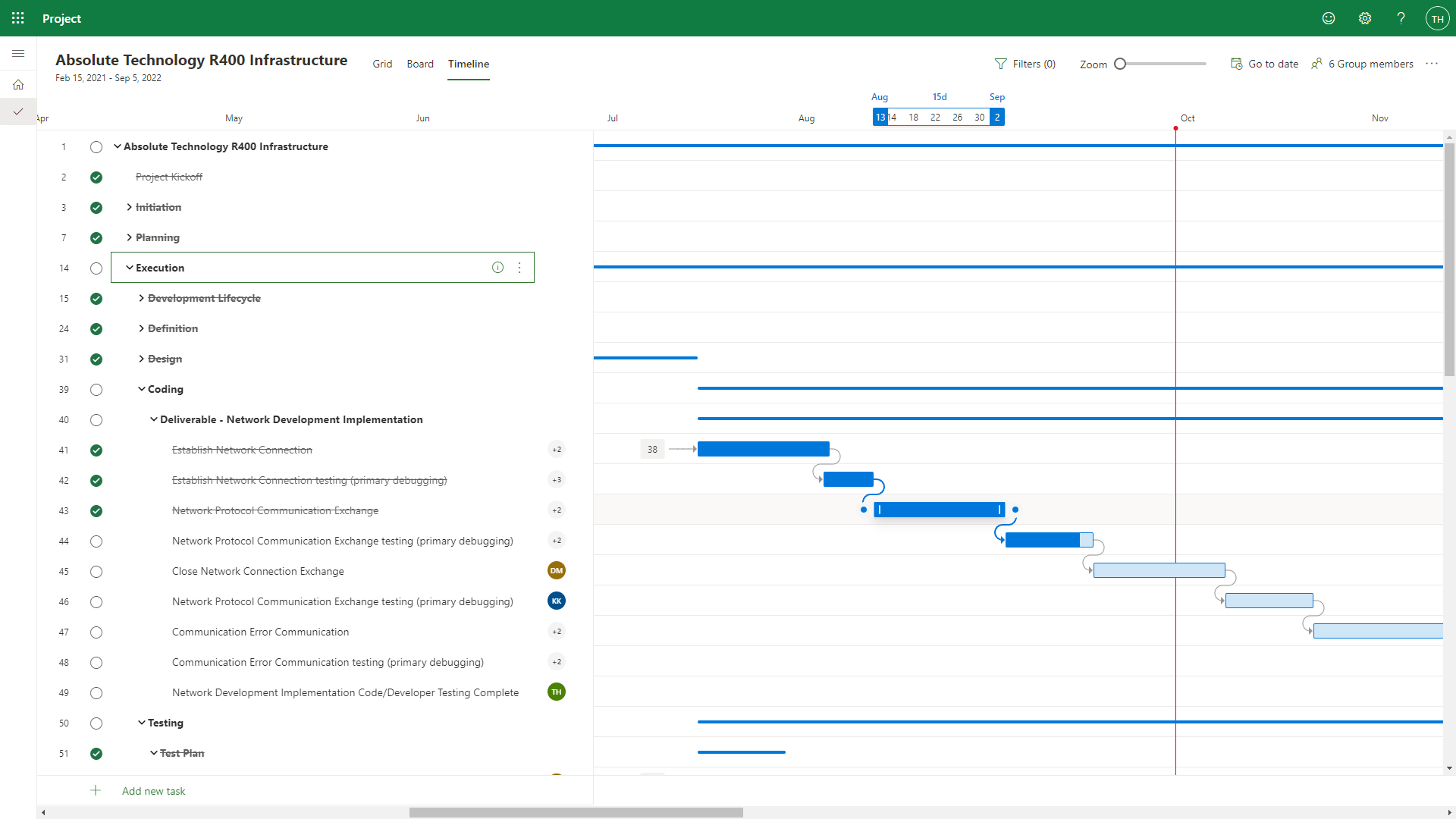

Assigned Work in Microsoft Project for the web – Timeline View



Visibility and Insights into Resource Management

In a typical portfolio, organizations will have proposals that have not yet been approved but that are requesting resources.  There will also be approved projects with only a high-level resource plan.  And then there will be active projects with detailed scope and assignments.

To get a complete picture of the demand on resources, our reports and dashboards must be able to view both proposed and approved allocations and hold these up against the actual work and tasks on projects.

For resource conflicts across active projects, look-ahead reports will show the remaining availability based on allocations to projects over the coming weeks and months.

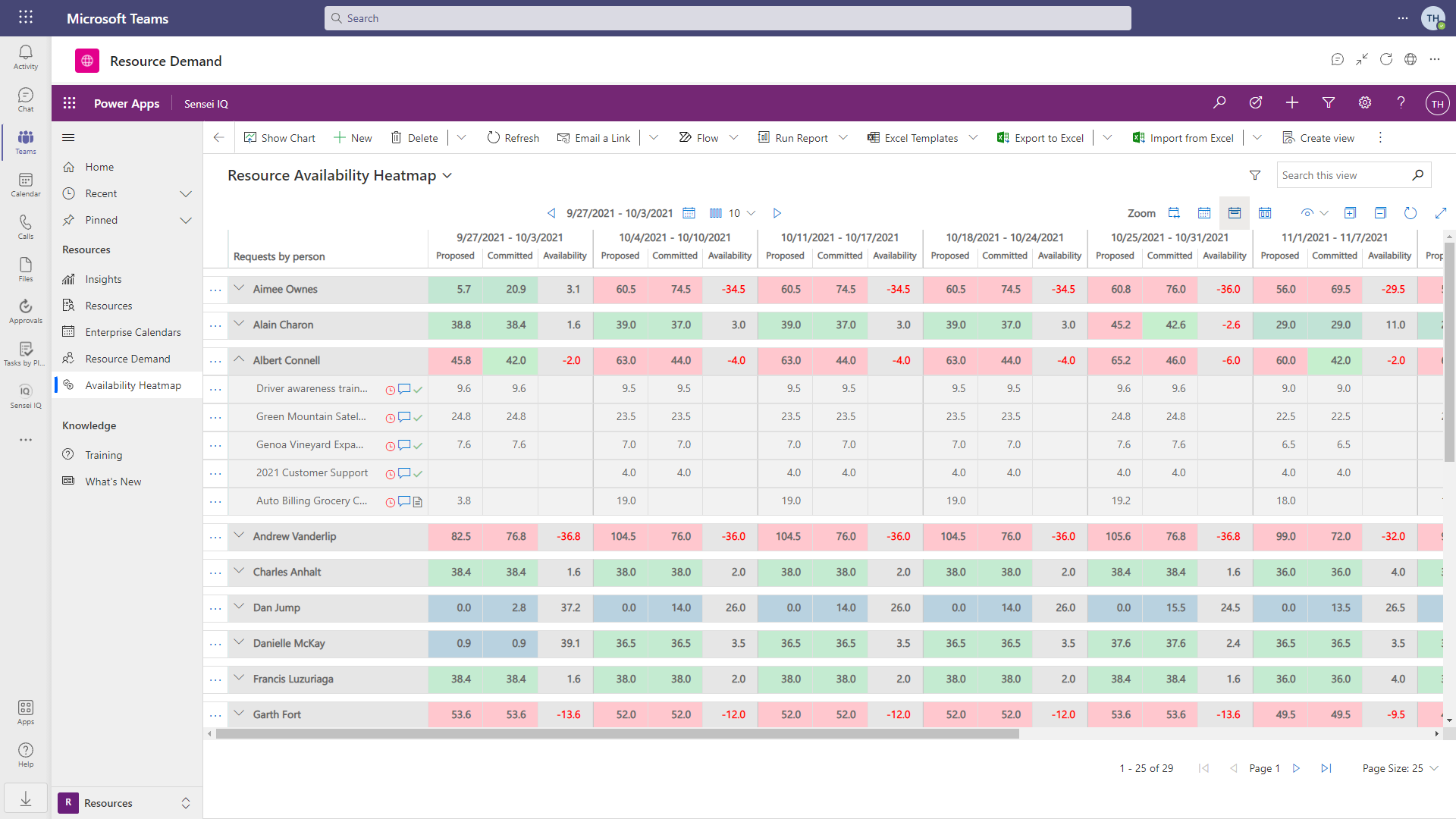

Resource Conflicts Across Active Projects
Resource Conflicts Across Active Projects



We also need to understand where projects are utilizing our resources without formal approval to do so.  This can happen when projects run late or if someone bypasses the system to assign work to our team members.  To expose that, we need to compare the approved allocations to assigned work on projects.

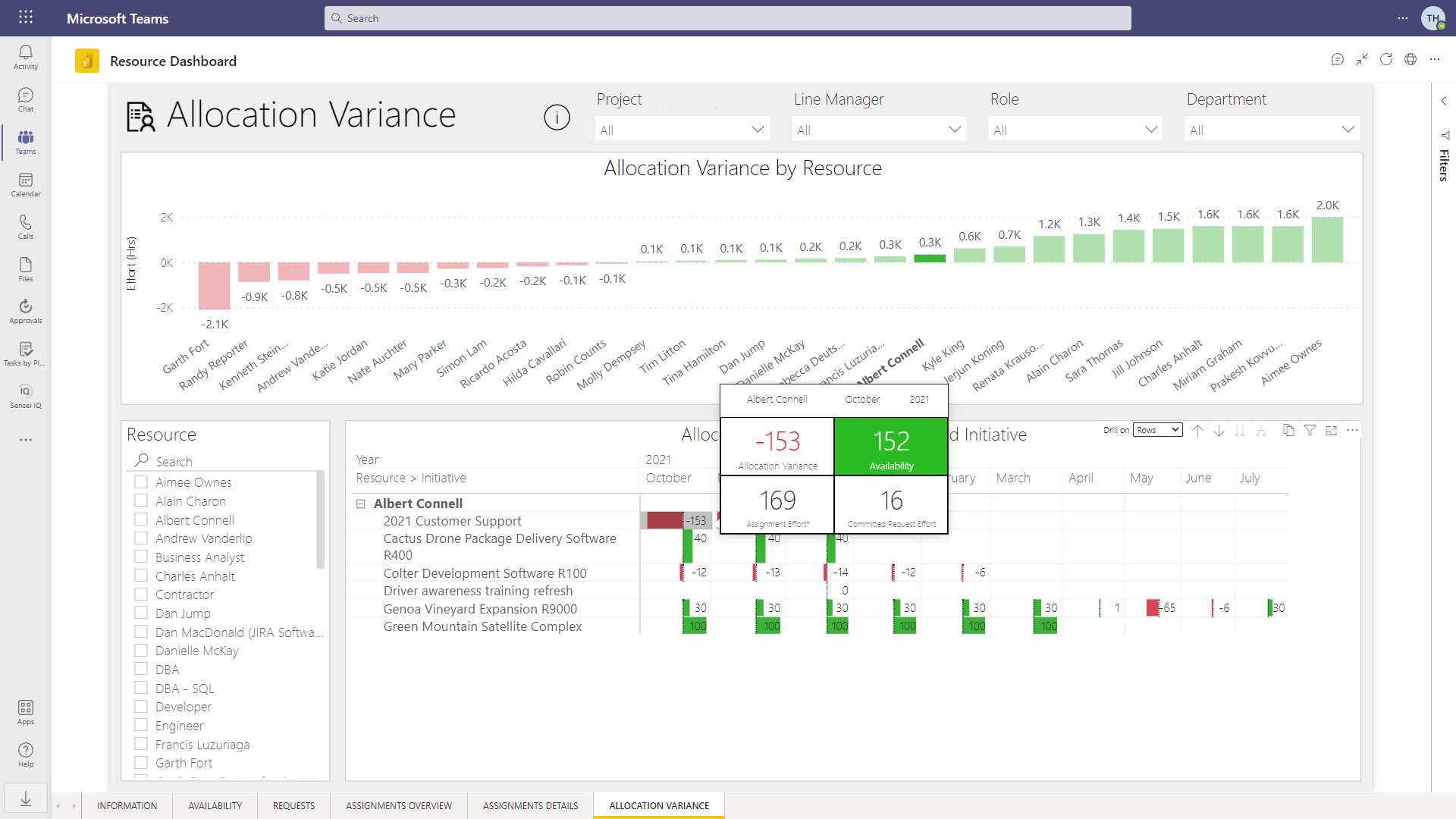

Resource Allocation Variance
Resource Allocation Variance



For longer term planning, we want to identify future resource demand and bottlenecks, based both on the pending requests from proposals and work already approved and in progress.  We typically want to see that demand by role or department.  This gives us a clear picture of where bottlenecks exist in the organization and where we may need to hire additional staff.

Resource Availability for Long-Term Planning
Resource Availability for Long-Term Planning



Conclusion

At Sensei, we think the practice of resource management doesn’t need to be hard or mysterious, and in fact it benefits from more simplicity and transparency.

If you’re not sure how to get started, reach out and let us show you how it can be done.
